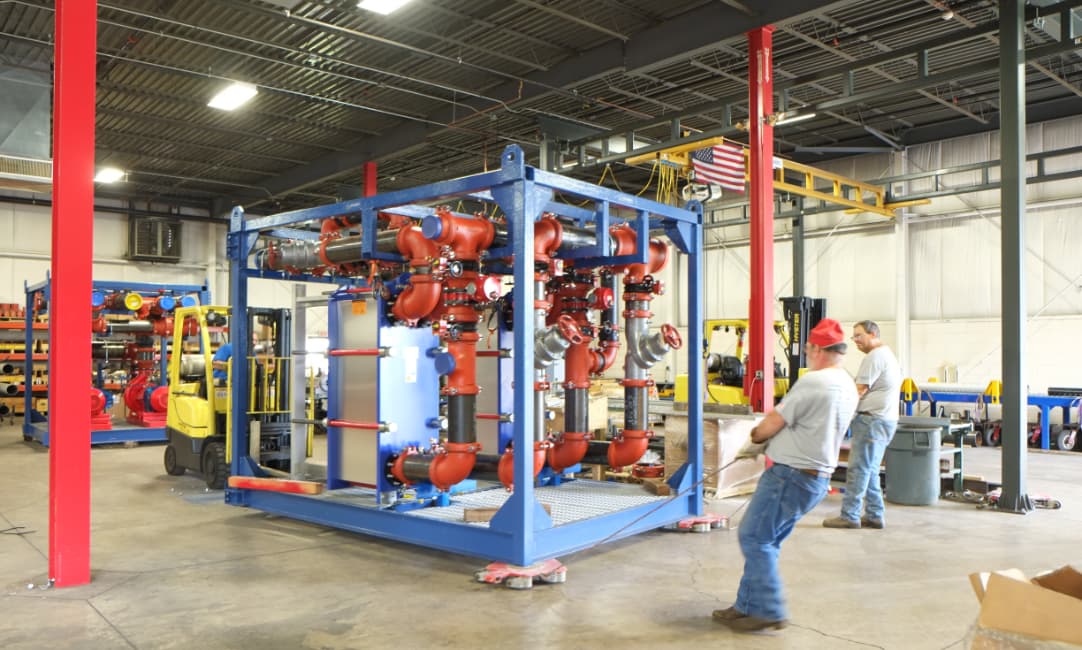

Modular construction moves a significant portion of the build into a controlled fabrication environment. Structural frames, piping assemblies, and multi-trade systems are engineered, fabricated, tested, and inspected offsite, then delivered to the jobsite as finished modules ready for setting and final connection. Field labor shifts from fabrication to installation, congestion on the deck drops, and critical path activities run in parallel rather than in sequence.
Binsky has invested in the engineering staff, shop capacity, and production planning discipline required to execute modular scopes on technically demanding projects. Our in-house mechanical and civil engineers work directly with the fabrication floor, so what gets modeled is what gets built and what gets built fits the first time.
Modular Construction vs. Traditional Construction Methods
| Factor | Traditional construction methods | Modular construction |
|---|---|---|
| Sequence | Fabrication follows site and foundation work | Fabrication runs concurrent with site work |
| Work environment | Exposed to weather delays and site conditions | Controlled shop conditions, year round production |
| Labor position | Work performed at elevation, in congested areas | Work performed at grade, in dedicated bays |
| Quality control | Inspected in place, field conditions vary | Repeatable process, documented inspection before shipment |
| Material handling | Multiple deliveries, extensive onsite storage | Consolidated deliveries, minimal laydown requirement |
| Rework exposure | Discovered during on site construction | Resolved in the model before fabrication release |
Industry research supports the operational case. Offsite construction is associated with reportable accident reductions of over 80 percent, driven largely by relocating work to ground level. Roughly 48 percent of on site construction accidents are fall related, against approximately 9 percent in a manufacturing plant environment. Waste follows a similar pattern, dropping from the 10 to 13 percent typical of field construction to around 5 percent in shop production, because material is cut and staged against a fabrication plan instead of estimated in the field. Consolidated module deliveries can reduce onsite deliveries by as much as 70 percent, which carries weight on constrained urban sites where every truck movement requires coordination.
For mechanical work specifically, the safety gain concentrates in the activities that generate the most field risk: overhead pipe fitting, elevated welding, and rigging in occupied or congested areas. Performing that work in a fabrication bay at grade changes the exposure profile of the entire installation.
Modular Construction Capabilities
Binsky designs, fabricates, and delivers modular systems across the full scope of commercial and industrial mechanical work.
- Custom module design and engineering support
- Pipe racks in copper, stainless steel, and carbon steel
- Multi-trade racks integrating piping, sheet metal, controls, electrical, and insulation
- Equipment racks and equipment skids
- Complete mechanical room fabrication through modularization
- Sheet metal fabrication and modular ductwork assemblies
- Plumbing fixture assemblies and carrier walls
- Process piping and high-purity piping modules
- Central utility plant and chilled water piping assemblies
- Structural steel frames engineered for rigging, transportation, and setting loads
- Two fabrication facilities in New Jersey and Pennsylvania
Design Considerations for Modular Construction Projects
Modularization decisions carry design implications, and the earlier they are addressed the greater the flexibility available to the project team.
- Repeatability. Systems with repeating configurations, such as data center cooling distribution, laboratory service risers, or patient room plumbing, generate the strongest return from an offsite construction approach.
- Transport envelope. Module dimensions are governed by permitted road limits and route availability. Oversize assemblies require special hauling permits, and permit conditions can dictate both module size and delivery routing. We establish these parameters before detailing begins.
- Rigging and access. Crane position, pick weights, door and shaft openings, and setting sequence determine how a system can be divided. A module that cannot reach its final position is a liability, not an asset.
- Interface tolerance. Field connection points require defined tolerance, and adjacent trades need to hold their coordinated positions. This is a coordination commitment across the project team, not a shop responsibility alone.
- Structural loading. Multi-trade racks impose concentrated loads at defined points. Structural engineering input during design avoids reinforcement work later.
- Procurement lead time. Equipment selections need to be locked earlier on modular construction projects because fabrication cannot start on an unresolved design.
- Front-loaded coordination. Modular delivery requires more design and coordination effort before manufacturing begins. That work is not additional effort so much as relocated effort, moved from field problem solving into the model, where resolution costs a fraction as much.
Production Planning
Preconstruction and modularization analysis
We evaluate the design for repeatability, identify candidate scopes, and quantify the field labor and schedule impact of moving that work offsite.
Model development and coordination
Modules are detailed in BIM, coordinated with all affected trades, and reviewed with the project team for approval.
Material procurement
Raw materials and long-lead equipment are released against the fabrication sequence. Early procurement gives the project a buffer against supply chain disruptions instead of discovering a shortage at the point of installation.
Fabrication release schedule.
Shop drawings are released against jobsite need dates, sequenced so modules arrive when the site is ready to receive them.
Shop fabrication and quality control
Assemblies are built, welded, tested, and inspected under controlled conditions with documented QA records.
Logistics and delivery
Transportation routing, permitting, staging, and lift planning are coordinated with the general contractor to minimize onsite storage and laydown requirements.
Field setting and connection
Crews set modules, complete tie-ins, and turn the system over for testing and commissioning.
Production planning is what separates modular construction that delivers from modular construction that disappoints. Binsky builds a production plan tied directly to the construction schedule.
Because labor hours and material quantities are tracked against a defined production plan rather than estimated in the field, cost and schedule visibility improve as fabrication progresses. Owners and construction managers get earlier warning when something moves.
Frequently Asked Questions
How do you define modularization?
Modularization is the process of dividing a mechanical system into shop-built assemblies engineered for transport, rigging, and field connection. It differs from general prefabrication in scope: modularization delivers coordinated multi-trade modular systems rather than individual components.
What types of modular structures does Binsky fabricate?
Pipe racks in copper, stainless steel, and carbon steel; multi-trade racks combining piping, sheet metal, controls, electrical, and insulation; equipment racks and skids; plumbing assemblies; modular ductwork; and complete mechanical rooms.
When should modular building be evaluated on a project?
During design and preconstruction. Modularization requires model coordination and interface definition before fabrication begins, so the decision has the greatest impact while the design is still developing. Projects with repetitive systems, compressed schedules, congested sites, or restricted site access are the strongest candidates.
How does modular construction affect the project schedule?
Published industry research reports schedule reductions in the range of 20 to 50 percent against traditional construction methods. On mechanical scopes, the gain comes from fabrication running concurrent with site and foundation work, shorter field durations because crews are setting and connecting modules instead of fabricating in place, and reduced sensitivity to weather and site access.
Where do the cost benefits of modular systems come from?
Cost performance is driven by field labor productivity, reduced rework, less material waste, lower onsite storage and handling requirements, and schedule compression that shortens general conditions. Published figures vary widely, from total project savings approaching 20 percent to a net premium where module design, logistics, and permitting are underestimated. That spread is precisely why we develop the cost case during preconstruction against the actual scope rather than applying a general assumption.
Do modular assemblies meet the same building codes as field-installed work?
Yes. Modules are engineered, fabricated, and inspected against the same building codes and applicable mechanical, piping, and fire protection standards. Shop conditions typically make code compliance easier to verify and document.
Can modular construction support FDA validated and high-purity systems?
Yes. Binsky’s hygienic division fabricates high-purity and process piping modules using orbital welding, with material traceability, weld documentation, passivation, and testing records supporting validation requirements.
How does Binsky verify that modules will fit in the field?
Modules are developed in a coordinated BIM environment with clash detection and interface control completed before fabrication release. Virtual walkthroughs allow the project team to review assemblies before fabrication, and dimensional quality control in the shop confirms the built condition matches the model.
How does offsite fabrication help with supply chain risk?
Material and equipment are procured and staged against the fabrication schedule well ahead of the field need date. Shortages surface during production planning, when there is still time to react, instead of during installation.
Where are Binsky’s fabrication facilities located?
Binsky operates two fabrication facilities, one in New Jersey and one in Pennsylvania, serving projects throughout the Northeast and Mid-Atlantic.
Discuss Your Project
Modular construction rewards early engagement. Bring us in during design or preconstruction and we will evaluate the scope, identify modularization opportunities, and build a production plan aligned to your schedule.
Get in touch to discuss your project or request a quote today.
